By choosing to purchase or hire any equipment from Unit Group, you are acknowledging and agreeing to comply with the terms and conditions outlined in the following transport guidelines.
We require a full 48hr’s notice prior to delivery/collection on a working day (weekend/bank holidays not included) for cancellation.
While we make every effort to plan and schedule deliveries based on agreed dates, it is important to note that we cannot provide a 100% guarantee on delivery dates. There are factors beyond our control, such as traffic conditions, road closures, driver illness, and unforeseen issues at depots, that may impact the delivery schedule. We appreciate your understanding and assure you that we will do our best to minimise any disruptions and keep you informed of any changes that may arise. We understand the importance of specific delivery dates, if urgency is a factor, we recommend considering a paid premium AM delivery slot. This option allows for the entire day to accommodate any unforeseen circumstances, although it is important to note that even with this selection, we cannot provide an absolute guarantee. We strive to prioritise timely deliveries and appreciate your understanding in situations that may arise beyond our control.














We will need to be informed of the following:
- Underground cables.
- Manhole covers/drains.
- Overhead cables, including the following:
- Height
- Type e.g Power, Electrical.
- Overhanging trees e.g. height of branches.
- The unit(s) will need to be lifted over other containers, fences, walls,
- buildings and any other obstacles.
- The unit(s) will need to go inside a building.
- The unit(s) to be double stacked on site
Failure to advise any of the above, may result in a full aborted delivery and collection charge.

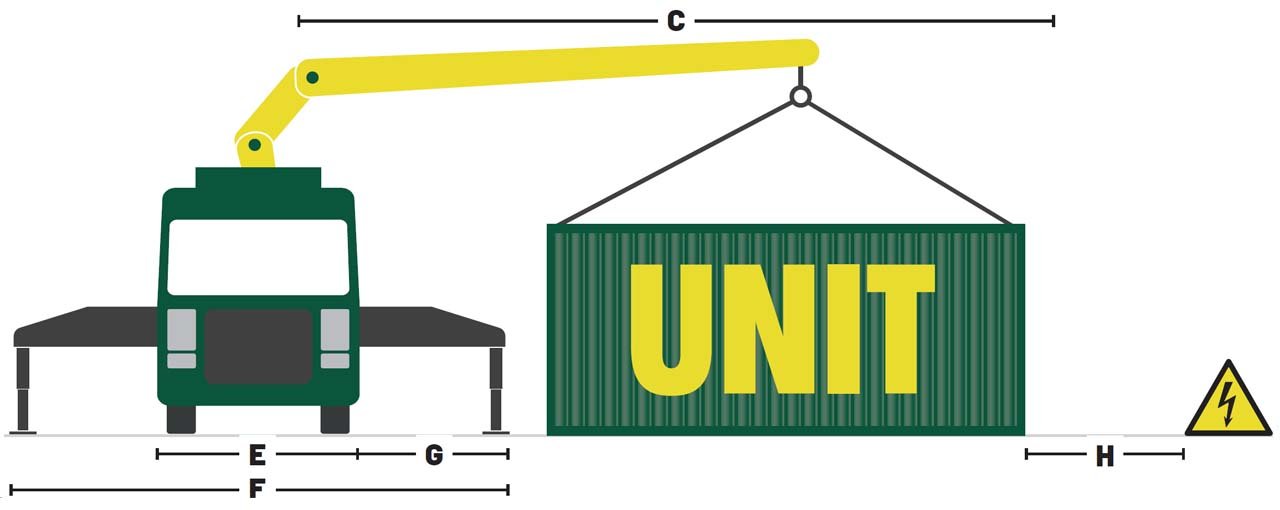

Rigid Delivery Requirements
A 11.75m = Length of lorry
B 8m = Clear height of crane
C 14m = Crane fully extended
D 3.8m = Unloaded lorry height
E 3m = Width of lorry
F 8.4m = Width between stabiliser legs
G 2.7m = Stabiliser leg fully extended
H 10m = Clearance between end of load and electrical cables
Important
Groundworks are the customers responsibility. An abort fee will be applicable if the groundworks are not suitable for the haulier to drive on (i.e mud, ice etc).
Rigid With Trailer Delivery Requirements
A 18.75m = Length of lorry with trailer
B 8m = Clear height of crane
C 14m = Crane fully extended
D 3.8m = Unloaded lorry height
E 3m = Width of lorry
F 8.4m = Width between stabiliser legs
G 2.7m = Stabiliser leg fully extended
H 10m = Clearance between end of load and electrical cables
Important
Groundworks are the customers responsibility. An abort fee will be applicable if the groundworks are not suitable for the haulier to drive on (i.e mud, ice etc).
Artic Delivery Requirements
A 16.65m = Length of lorry
B 8m = Clear height of crane
C 16.2m = Crane fully extended
D 3.9m = Unloaded lorry height
E 3m = Width of lorry
F 9m = Width between stabiliser legs
G 3m = Stabiliser leg fully extended
H 10m = Clearance between end of load and electrical cables
Important
Groundworks are the customers responsibility. An abort fee will be applicable if the groundworks are not suitable for the haulier to drive on (i.e mud, ice etc).
